An incentive exception approval workflow keeps audits short.

October 23, 2026
Puneet Gupta
Puneet Gupta
Puneet Gupta
Decorative image: Aesthetic background with abstract shapes and colors.
An incentive exception approval workflow keeps audits short.

Key Insights

In the Alexander Group's 2025-26 survey, 65% of firms said they need to improve the governance of their sales incentives. In my conversations with finance controllers, that gap usually has a name: the exception approved on a call and applied in a spreadsheet the week before payout.

Exceptions are often right for the business. A split agreed late, a waiver for a territory hit by floods, a guarantee for a new joiner. The problem is the record. When an auditor asks why one payee received more than the plan allowed, the answer sits in someone's inbox, or with someone who has since left.

An incentive exception approval workflow fixes that by giving every exception the same fields: requester, rule overridden, amount, reason, evidence, approver and date. Approval limits by amount, separate maker and checker roles, and locked payouts turn the record into a control the auditor can test under Section 143(3)(i).

A question worth asking the finance controller this week: how many exceptions were approved in the previous quarter, and could each one be shown with its approver?

Home
Blog

An incentive exception approval workflow keeps audits short.

Table Of Contents

Home
Blog

An incentive exception approval workflow keeps audits short.

ReKennect : Stay ahead of the curve!
Subscribe to our bi-weekly newsletter packed with latest trends and insights on incentives.
Thank you! Your submission has been received!
Oops! Something went wrong while submitting the form.

Your data is in safe hands. Check out our Privacy policy for more info

Get a Personalised Demo!

Understand how Kennect can help your organization

Gartneer logo
G2 Logo
G2 Logo
Home
Resources
Blogs

An incentive exception approval workflow keeps audits short.

An incentive exception approval workflow keeps audits short.

Author:
Puneet Gupta
Read time:
23 Oct 2026
Published on:
23 Oct 2026
Modified on:
23 Oct 2026
Blog Summary

In the Alexander Group's 2025-26 survey, 65% of firms said they need to improve the governance of their sales incentives. In my conversations with finance controllers, that gap usually has a name: the exception approved on a call and applied in a spreadsheet the week before payout.

Exceptions are often right for the business. A split agreed late, a waiver for a territory hit by floods, a guarantee for a new joiner. The problem is the record. When an auditor asks why one payee received more than the plan allowed, the answer sits in someone's inbox, or with someone who has since left.

An incentive exception approval workflow fixes that by giving every exception the same fields: requester, rule overridden, amount, reason, evidence, approver and date. Approval limits by amount, separate maker and checker roles, and locked payouts turn the record into a control the auditor can test under Section 143(3)(i).

A question worth asking the finance controller this week: how many exceptions were approved in the previous quarter, and could each one be shown with its approver?

What the 2026 governance research says

In the Alexander Group's 2025-26 Sales Compensation Trends Survey, 65% of firms said they need to improve the governance and program management of their sales incentives. In the same survey, 97% of companies changed their plans for 2026.

Exceptions are where governance is tested. A WorldatWork case study described one company where in-plan add-on bonuses and short-term SPIFs cost 32% of the total incentive payment, about $24.6 million. The fix was guardrails for creating and approving SPIFs and contests.

Sources: Alexander Group, 2025-26 Sales Compensation Trends Survey research briefing, hundreds of companies across 11 industries · WorldatWork Workspan Daily, Governance and Operations Are Foundational to Sales Comp Success, 16 July 2026 · figures are survey findings and one case study

Two in three firms want stronger incentive governance, and exceptions are where that governance is tested first.

‍

What counts as an incentive exception

An exception is any payout decision the plan rules did not make on their own. In many sales teams, exceptions fall into eight types.

  1. A manual adjustment to a calculated payout.
  2. An override of a slab, target or gate for one payee.
  3. Credit moved to a different rep or period after the close.
  4. A split agreed after the deal closed, which split sales compensation covers in detail.
  5. A contest or SPIF launched during the period.
  6. A waiver of a qualifying condition, such as attendance or a ratio gate.
  7. A guaranteed payout for a new joiner.
  8. A recovery reduced or waived.

Each one can be right for the business. Each one also moves money outside the approved rules, which is why it needs a record.

An exception is a payout decision made outside the plan rules, and every one of them needs a reason, an approver and a date.

‍

Why exceptions become an audit question in India

Under Section 143(3)(i) of the Companies Act 2013, the auditor reports on whether the company has adequate internal financial controls with reference to financial statements, and whether those controls operate effectively. For listed companies, Section 134(5)(e) requires directors to state that internal financial controls are in place and operating effectively.

The Act defines internal financial controls to include the prevention and detection of frauds and errors, and the accuracy and completeness of accounting records. An exception approved on a call, applied in a spreadsheet and paid with the rest of the payout leaves nothing for the auditor to test.

Some private companies below set turnover and borrowing limits are exempt from the 143(3)(i) report. The discipline still protects the incentive budget.

Sources: Companies Act 2013, Section 143(3)(i) as amended by the Companies (Amendment) Act 2017, and Section 134(5)(e) with its Explanation · ICAI Guidance Note on Audit of Internal Financial Controls Over Financial Reporting · this post is not legal advice

An exception without a record is a control the auditor cannot test, and a payout the company cannot defend.

‍

What an incentive exception approval workflow should record

A workflow is the set of fields every exception carries from request to payout. The auditor asks for the same fields, so the record answers the audit as it is created.

Fields an incentive exception approval workflow should record, and why the auditor asks for each

FieldWhat it holdsWhy the auditor asks
RequesterWho asked for the exceptionShows who initiated the change
Payee and periodWhose payout, for which closeTies the exception to one payout
Rule overriddenThe plan clause, slab or gate set asideShows what the approved plan would have paid
AmountThe change in rupeesLets the auditor test against approval limits
Reason and evidenceWhy, with the supporting document attachedShows the decision had a basis
ApproverWho approved, separate from the requesterShows maker and checker were different people
Timestamp and expiryWhen it was approved, and whether it repeatsShows the exception did not become a standing rule by default

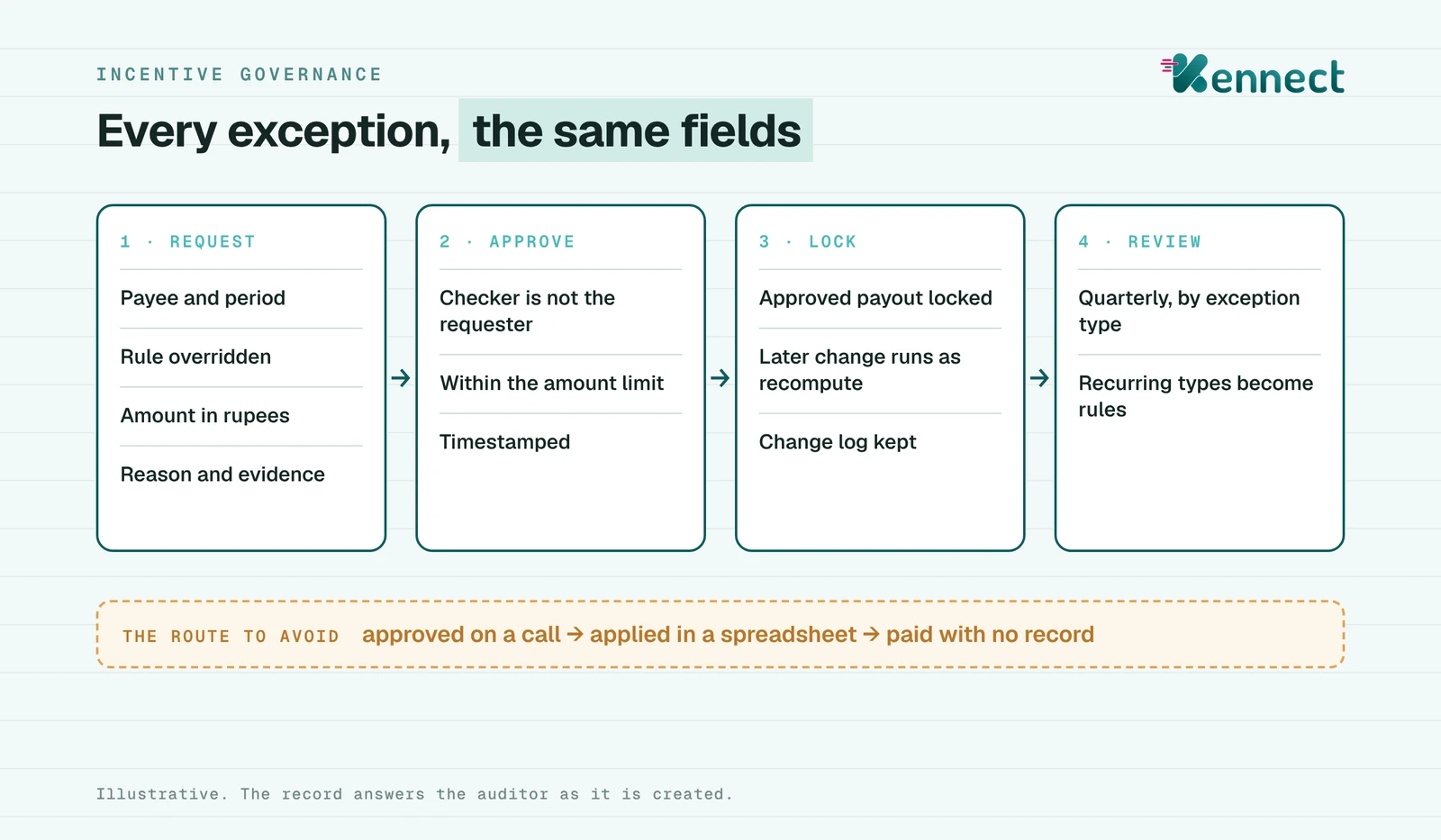

An incentive exception moving through four cards: request with reason and evidence, approval by a separate checker within an amount limit, a locked payout and a quarterly review by exception type, with an exception approved on a call marked in amber as the route to avoid.
Illustrative. Every exception carries the same fields from request to locked payout.

An exception recorded outside the payout is one of the commission calculation errors that repeat every cycle.

When the exception record holds requester, rule, amount, reason, approver and date, the audit trail builds itself.

‍

How to set up an incentive exception approval workflow

Six steps put a workflow in place before the next close.

  1. Define exceptions in the plan document. List the eight types and state which ones are allowed.
  2. Set approval limits by amount and role. A regional manager approves small adjustments, while finance and the sales head approve larger ones. In SalesGlobe's 2026 research, 52% of companies had a formal mega-deal policy.
  3. Separate maker and checker. The person who requests an exception never approves it.
  4. Require a reason and evidence. No exception moves without both.
  5. Lock approved payouts. A change after approval runs as a recompute with its own reason, inside a window the plan sets.
  6. Review exceptions every quarter, by type. An exception that recurs is a rule waiting to be written, the same way a mid-year incentive plan change needs a dated version.

For the wider governance model, including who owns a change, see the governance guide to managing sales incentives.

Count the previous quarter's exceptions by type. The three largest types are the first three rules to write into the plan.

Limits, separated roles, required evidence and locked payouts turn an exception from a favor into a control.

‍

How Kennect handles incentive exceptions

In the finance teams we work with, the exception log usually lives in email. So we keep every exception inside the payout record it changes.

Approvals and locks. Manual adjustments go for approval before they reach a payout, and approved payouts are locked. Scheme changes pass maker-checker approval before any payout uses the revised version. Admins set how far back a recompute can reach.

Audit trail. Every edit sits in a change log with who made it and when. Plans are held as dated versions. Any payout drills down to the data behind it, and the record exports for the auditor.

AI today. Every payout traces back to the plan and KPI behind it, and tracing to the underlying data follows by the end of December 2026. AI-assisted query resolution answers many payee queries before they become exceptions.

AI next. End-to-end exception handling, expected between January and March 2027, will let AI flag a payout exception and carry it through to resolution. AI root-cause analysis and validations, with timing to be confirmed, will check data, calculations and payouts before release.

In one deployment at a mid-sized Indian pharma company with more than 1,000 medical representatives, the time from period close to payout fell to 5 days, against 2 to 3 months before.

Source: Kennect claim register · anonymized mid-sized Indian pharma deployment, 1,000+ medical representatives · close to payout before and after go-live

Exceptions recorded inside the payout, with approvals and locks, give finance a trail it can sign and an auditor a control to test.

‍

What this means before your next audit

Exceptions will keep happening, because markets move faster than plan documents. A company that records each one with a reason, an approver and a date can show the auditor every rupee paid outside the rules, and why.

Every exception recorded inside the payout, with its reason and approver, is a control the auditor can test.

65% of firms say incentive governance needs work. An approval workflow with limits, separated roles and locked payouts closes that gap before the audit.

See how Kennect gives finance an audit trail behind every payout.

See Kennect for finance and compliance →
